Project: Connection
The connection of the ski areas in Špindlerův Mlýn is one of the largest projects in the modern history of Špindlerův Mlýn. Here you will find current information on what awaits us and the entire history of the project.
Current: Construction of the new chairlift begins in spring 2026
What does this mean for skiers?
New heated six-seater chairlift with protective bubble from Leitner Ropeways P1 at Hromovky upper station
In addition, a complete red Přehradní slope will be built along the chairlift route
Opening of the Audi line Přehradní chairlift for skiers in December 2026
Map to view HERE
Schedule of key works for 2026
- 04/2026 Start of introduction of the Audi line cable car technology Dam, excavations for the lower station and network connection.

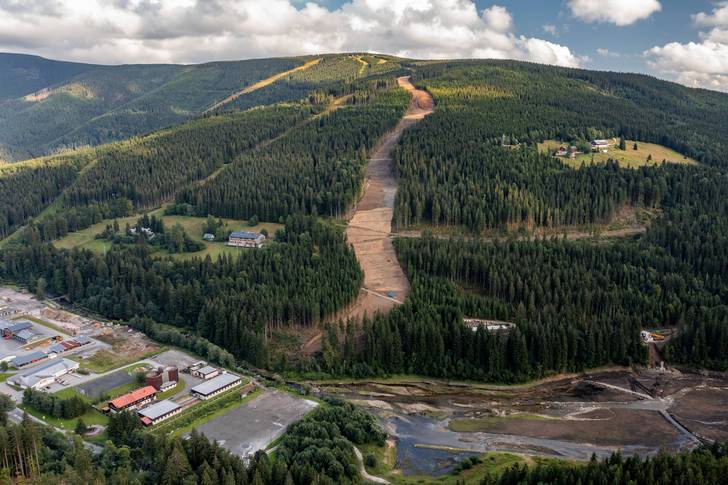

- 05/2026 Excavations for the upper station, deforesting the route, laying snow on Medvědín and starting work on the road bridge.
- 06/2026 Modeling of the Předhradní ski slope, surface modifications on P1, installation of technologies in the gas station and a bridge over the Elbe.

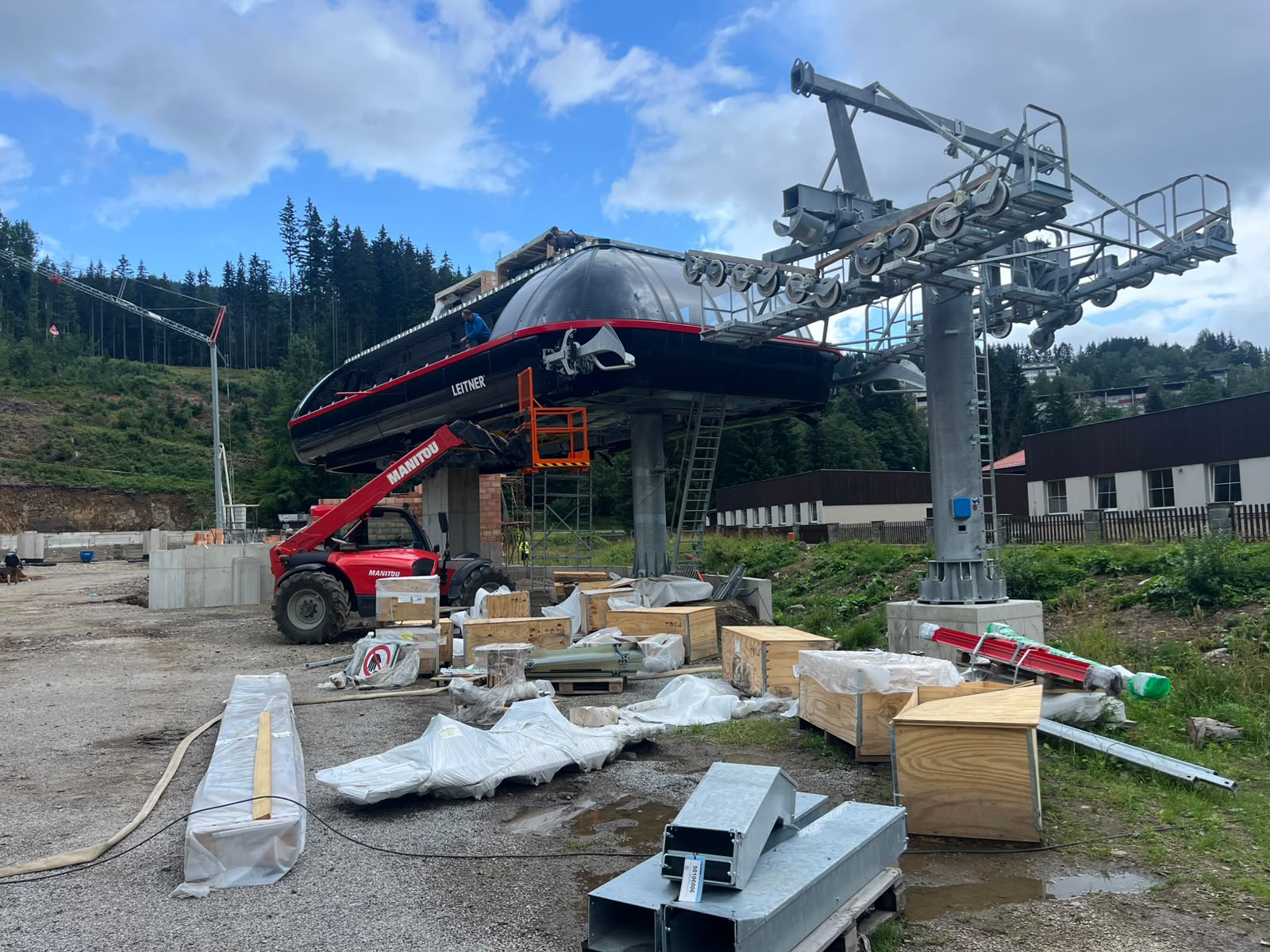

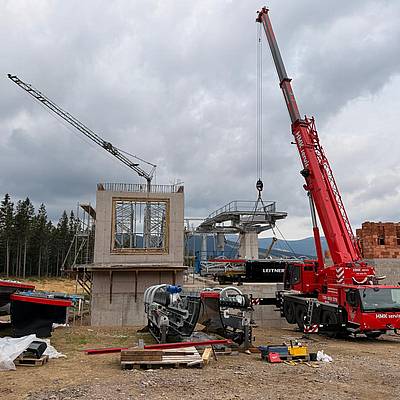

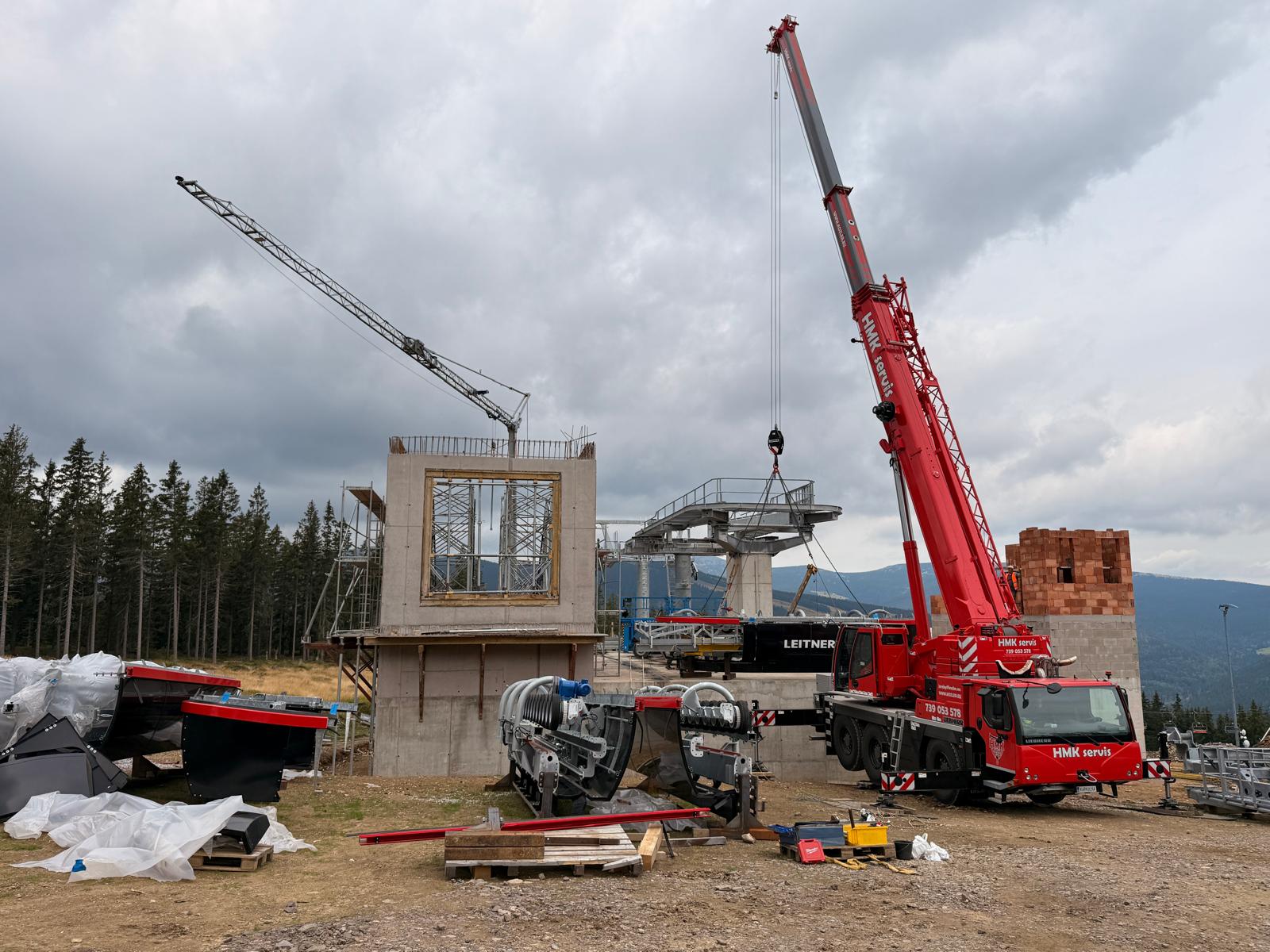

- 07/2026 Concreting of stations, installation of cable car supports and installation of the steel structure of the bridge over the road.
- 08/2026 Rigging (rope tensioning), completion of the construction part of the lower station, release of the route for the future cable car to Medvědín.
- 09/2026 Completion of station assembly, preparation of cable car tests, installation of snow machines and completion of road bridge construction.
- 10/2026 Final landscaping and grassing of slopes, completion of surfaces in parking lot P1.
- 11/2026 Cable car test operation and revision, start of complete snowmaking system in full mode.
- 12/2026 Surveying of the actual execution, administration and commissioning for the public.
